SAP Demand Management Tutorial: MD61, MD62, MD04, MD74, MD75
What is Planned Independent Requirement(PIR)? Planned Independent Requirements (PIR) are used to...
A production order defines which material is to be processed, at which location, and at what time and how much quantity is required. It also defines which components and sequence of operations are to be used and how the order costs are to be settled.
In this tutorial- you will learn
Production Order creation is required to produce the material and consume the components which are used, and it also specifies the sequence of operations to be performed at the work center.
The release of order signifies that the order is ready to be executed at the shop floor. You can do an automatic release of order also during creation mode by using relevant production scheduling profile in the material master with auto release indicator set.

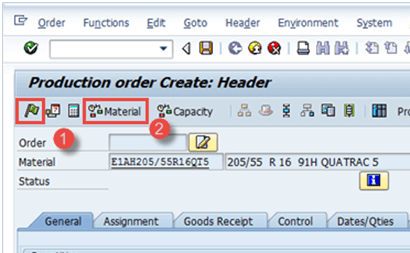

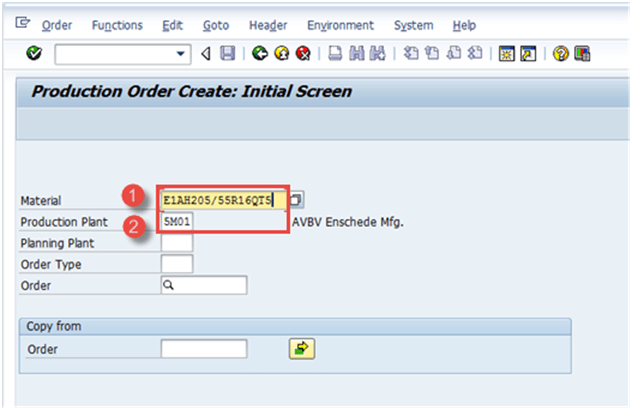

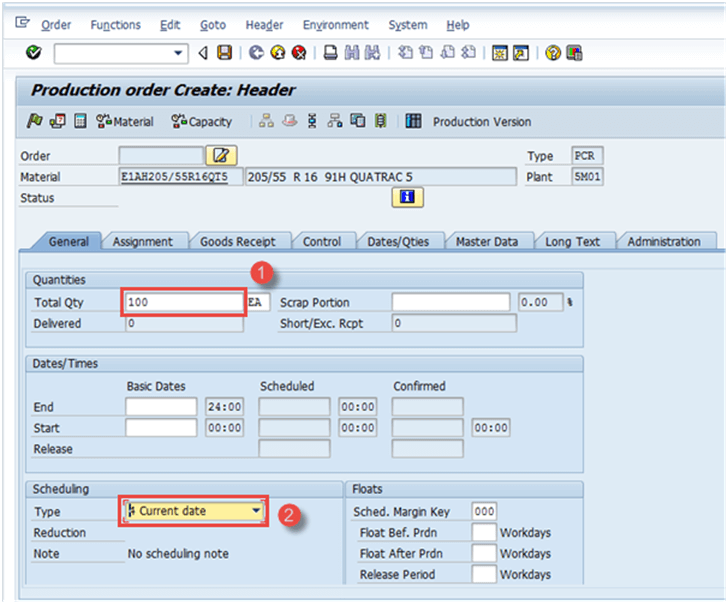

Step 1) From SAP Easy access screen open transaction CO01
After filling in all the fields, click
or press Enter to go to the next screen.
Step 2) In this Screen
After filling the entire fields press click
to confirm, the system will then copy BOM and Routing data in the order.
Step 3) In the same screen,
Note: You can also decide not to release the order if there are missing parts found in availability checks.
Click button
to save, the following message will show in the bottom left corner:
.
Planned orders are the result of MRP run and should be converted to production order for further execution process.
You cannot directly declare production using planned orders and, therefore, it needs to be converted to Production Order.
Once, planned order is converted to production order, planned order gets deleted from the system and is no longer available to be considered in MRP (Material Requirement Planning).

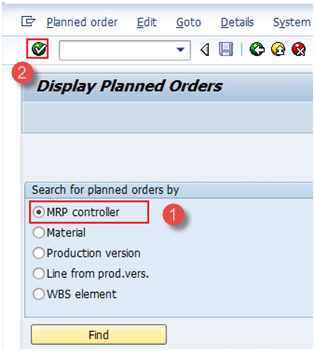

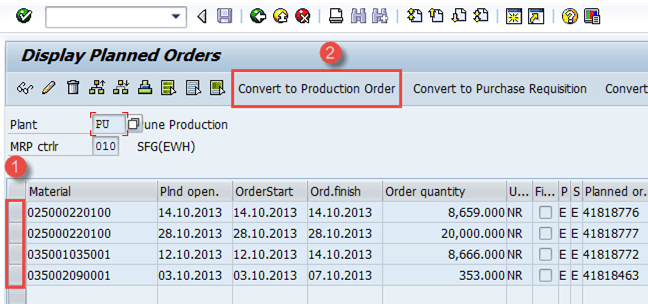

Step 1) From SAP Easy access screen open transaction MD16
The system will show the screen as below.

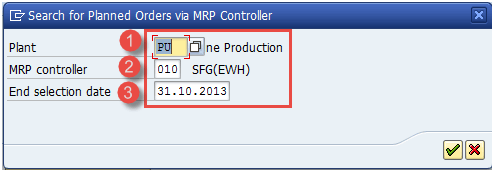

Step 2) In this screen, we will fetch the planned orders based on MRP controller and selection dates.
Click right mark sign from the bottom or enter from the keyboard to move to the next screen.
Step 3)In this screen,
Production orders will be created after conversion of planned orders.
You might require to change production order incase if your business wants to change some planning quantity or if BOM/Routing has been changed after the order has already been created.

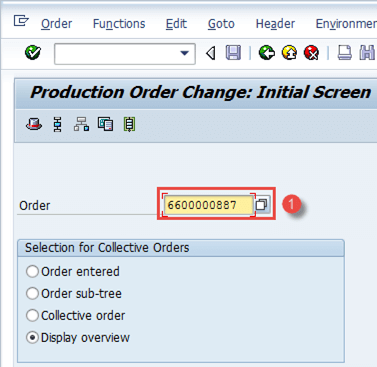

Step 1) From SAP Easy access screen open transaction CO02
In the same window you can see "Display Overview" button is selected, it is selected by default.
After filling in all the fields, click
to go to the next screen.
Step 2) In this screen, the order will be modified.
After finishing all modifications, click button
to save the order. The system will show a message like
Order number saved 6600000887 at the lower left corner.
Step 1) From SAP Easy access screen open transaction CO15, three activities occur at the same time with confirmation.
After filling in all the fields, click
to go to the next screen

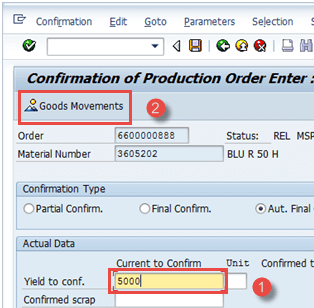

Step 2) In this screen, we will enter the actual yield quantity to be confirmed.

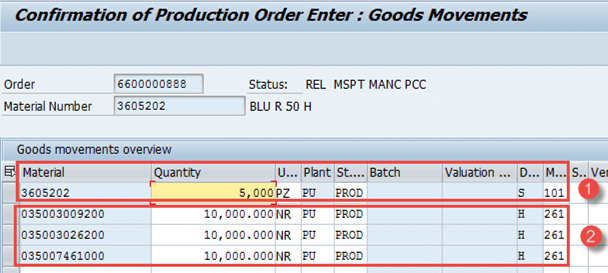

Step 3) In this screen, you will see the goods receipt of parent material and goods issue of components.
If the control key of the last operation in the order specifies automatic goods receipt, the system automatically posts the produced material to unrestricted stock.
Automatic goods receipt can also be activated by the production scheduling profile in the material masterwork scheduling view.
If you confirm an order with components that have the Backflushing indicator set in the material master MRP1 view, the system automatically posts a goods issue (GI) for these components.
The system will show a message like
at the lower left corner, to hint how many goods movement are posted successfully or failure.
Failed goods movements due to a deficit of stock for consumption are reprocessed manually.
Technical completion of the order is required when production order is either fully delivered, or it is not to be processed further at shop floor.
After technical completion order status changes to TECO, no further goods movement can be done against the order.
Order is no longer available in MRP run and gets deleted from stock/requirement list.
The controlling department can then carry out the variance calculation on the production Order after TECO status.
Step 1) From SAP easy access, open transaction CO02
Click
to next screen after filling all fields,

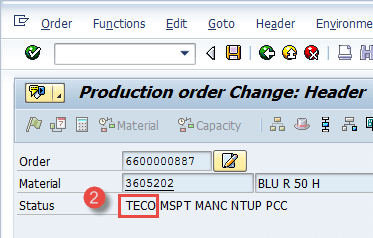

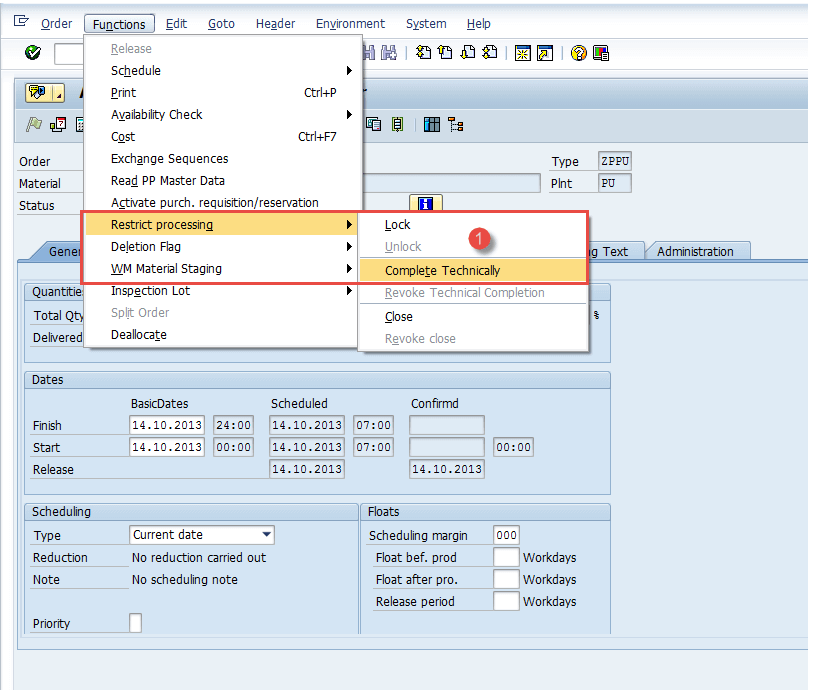

Step 2) In this screen, we will see how to place production order to TECO status,
Troubleshooting
What is Planned Independent Requirement(PIR)? Planned Independent Requirements (PIR) are used to...
Work center is an organization unit where manufacturing activities are performed. In other words,...
A routing is a description of which operations or list of activities has to be carried out during...
What is Production Planning? Production Planning is the process of aligning demand with...
What is Bill of Material (BOM) and its role? A bill of material is a complete, formally structured list...
There are many reports available in SAP pertaining to Master Data, Production Orders and Goods...
